Using Big Picture Analytics to Power Software Estimation

By analyzing past project metrics, QSM’s suite of tools enables your team to reduce wasted time and effort when creating estimates.

by Keith Ciocco (June 11, 2020)
Using Big Picture Analytics to Power Software Estimation

Imagine a software development process where “Big Picture” estimates can be generated before detailed planning takes place, where the estimates can be accessed on the web, and where only three or four inputs are needed to generate reliable information. This process would include intelligent models that take into account historical data and there would be a back office team that specializes in software customization available to do the heavy lifting. Finally, there would be business analytics and industry data (plenty of both) to help with project target negotiations and risk trade-off analysis.

Thankfully, there are science-based estimation solutions available that include the capabilities mentioned above. These packages can make estimation easier, more transparent, and help manage the uncertainty that can come with early planning. There are technology organizations that are using these types of tools to improve their time to market and the accuracy of their software development estimates.

But there are many organizations that still struggle with estimation. They spend millions of dollars each year developing and delivering software. The planning usually starts with senior management asking tough questions about cost and schedule targets. The project leads then try to come up with effort estimates for each person on the project based on experience and gut feel. These effort numbers are tallied up in spreadsheets to come up with an overall estimate, the numbers are usually negotiated and then a final estimate is born. The problem with this process is that it takes a long time to carry out and the estimates are usually inaccurate. This is because the methods don’t take into account the non-linear relationships, integration, and overhead that we often see in software development.  When the estimates are off, millions of dollars are spent trying to change course. The rest is history.

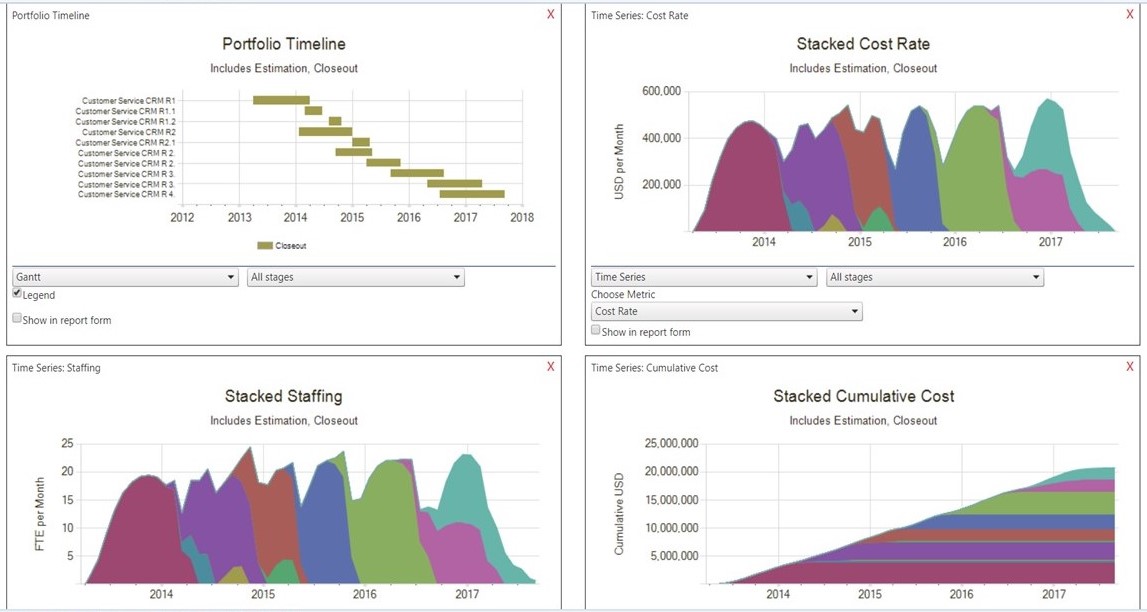

Let’s look at a case study showing an estimate that leverages a science-based approach in QSM's tool, SLIM-Collaborate. Ideally it starts with some historical data. In the first view below, there is a portfolio of projects stored in a centralized database. In the second view, with the click of a button, the analytics for all of these projects can be shown. These analytics can communicate the cost, duration, scope, and productivity numbers from the past. These numbers can also be leveraged to improve accuracy on future estimates and can help tremendously with process improvement efforts.

Software Estimation Big Picture

Software Estimation Big Picture Analytics

In the next view, we see where the project lead can begin the estimate after looking at the previous analytics. The project target information is entered and, in this case, it would be ballpark scope, time and effort. In this scenario, a back office professional had created an estimation template customized to a specific project environment and then uploaded the template to the project lead’s web instance. The back office professional took into account the resource and productivity data for this particular project environment.

Software Estimation Big Picture Analytics

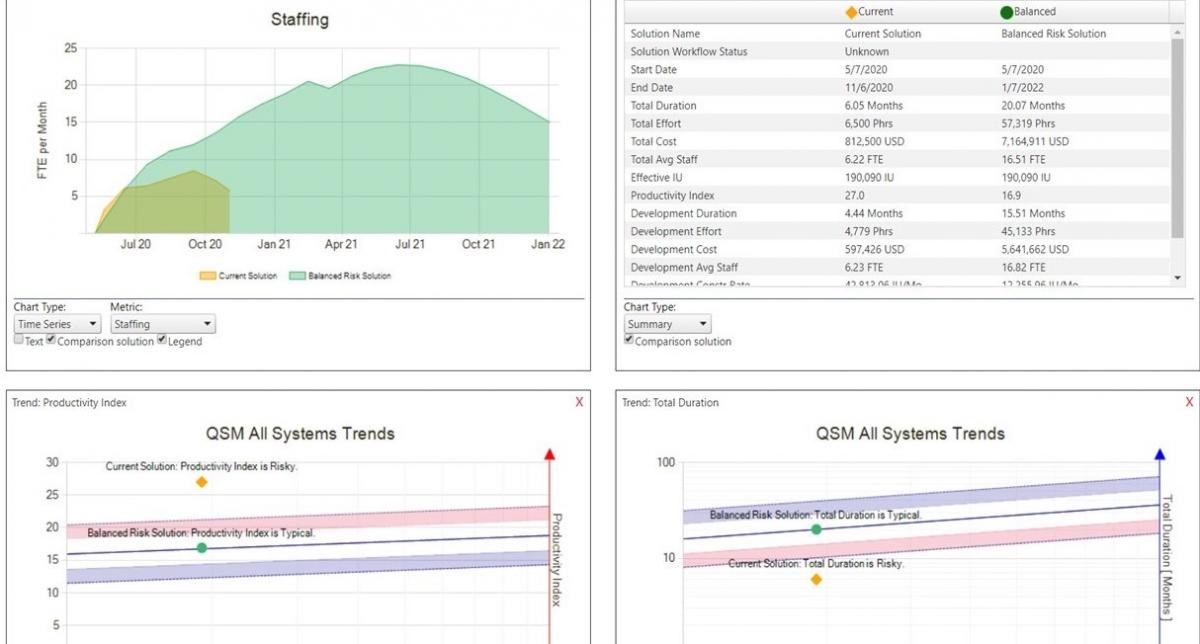

The project lead hits 'OK' and then can see what the upcoming project should cost, how long it should take, how many people are needed, and a reasonable scope that can be delivered within the targets. In addition, a wealth of analytics comes back that provides industry trend comparisons, risk charts, and contingency plans so that the project goals can be communicated and negotiated effectively.

Software Estimation Big Picture Analytics

Project and portfolio estimation solutions like SLIM-Collaborate that leverage science-based models can improve estimation accuracy, transparency, and ease of use. In addition, the collaboration capability that these tools bring to the table can be part of a positive work environment where management and stakeholders are on the same page early in the planning process when major decisions are often made.
